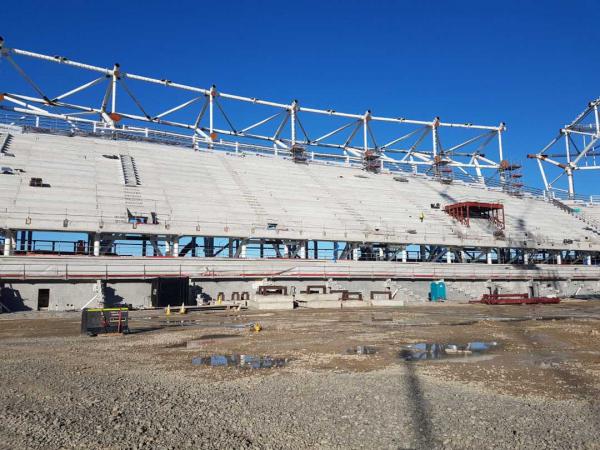

McKendry Construction was the successful tenderer to supply precast plats to Te Kaha Stadium which means that McKendry Construction is the largest supplier of precast concrete for the Te Kaha Stadium build, the new stadium is the largest of the anchor projects in Christchurch.
We secured the lease of additional 10000 m2 of manufacturing and storage area and commenced manufacturing in May 2023 of the 1721 plats required which equates to a massive 11 kilometers and 10000 tonnes of precast concrete with over 500 tonnes of reinforcing in the plats.

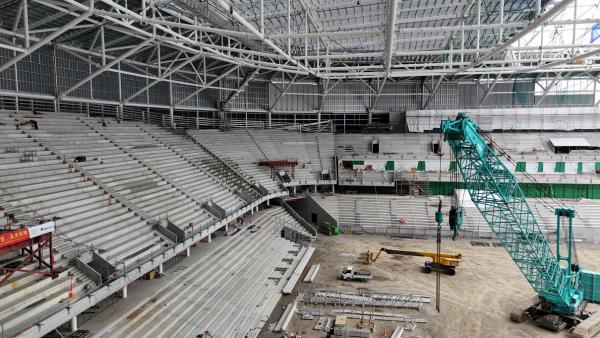

To meet delivery programme Mckendry Construction manufactured up to 8 plats per day to meet the Main Contractors requirements, we also manufactured very large double flight precast stairs to the West Stand, the majority of these are 20 tonnes each including 2.5 tonnes of reinforcing per stair. The final precast units manufactured were the 28 egress precast stairs.
Total final figures for Te Kaha Stadium precast supply from McKendry Construction was 1773 precast units, 4310 cubic metres of concrete with a total weight of 10775 tonnes of concrete all delivered as per Main Contractors programme.
For future large infrastructure projects we have the ability to significantly increase manufacturing, storage, cranage and labour resources as required.
McKendry Construction was contracted by Leighs Construction to manufacture and install the Learning and Research Center panels for the new Lincoln Science building. Stage 1 was 18 panels averaging 26 tonnes each installed in two days, followed by the six rocking shear wall panels weighing between 52 and 62 tonnes each, including 7 tonnes of reinforcing in each panel.
These were transported to site on specialist heavy transport trailers and then fitted with Techtonus seismic units increasing the weight of the panels by 3 tonnes each. The panels were rotated from the trucks using two cranes. A 250 tonne Main crane and a 160 tonne Tailing crane. The lifts went smoothly erecting the massive precast panels in two days. The coordination effort including multiple planning meetings between the main contractor and McKendry Construction meant the whole process went smoothly.
It was precise planning with structural engineers, temporary works engineers, precast lifting design engineers, the draughting team, the Techtonus team, reinforcing and concrete suppliers, structural steel, transport, crane and access equipment contractors, the precast install team and the health and safety teams to ensure the whole process went without a hiccup.
McKendry Construction was awarded the contract for 11 separate buildings for Fletcher Living Worcester Terraces at the end of 2019. We commenced manufacturing early March 2020, recommenced casting post lockdown and completed manufacture of 517 precast units by January 2021.
Detailed Pre tender planning included multiple meetings to discuss best solutions for; manufacturing, precast transport, site craneage, speed of precast erection and architectural finishes.
A good working relationship between Fletcher Living, McKendry Construction, Architects and Engineers ensured all precast was manufactured to shop drawing specification and all units were erected without any delay. The majority of precast units were bespoke and featured high quality timber board architectural finishes .
A total of 1700m3 of concrete equated to 4250 tonnes of Quality precast componentry delivered within budget and two months ahead of the scheduled construction program.
McKendry Construction worked in conjunction with Southbase Construction to manufacture the shearwall panels for the new Christchurch Library.
The shearwalls are made up for the east core and the west core with another two independent panels.
These panels as far as we know are the largest panels to be manufactured in New Zealand and on a world standard are close to being some of the largest panels to be manufactured.
McKendry Construction manufactured nine of the thirteen panels required the smallest weighing 22.0 tonnes and the heaviest a massive 132.0 tonnes.
The complex reinforcing cage averaged 10 tonnes per panel and took approximately a week to fabricate.
McKendry Construction was awarded the precast supply contracts for the iconic Riverside market, Guthrey Centre and Logie Building developments in Cashel Mall.
Thorough planning and coordination between main contractor, client, draughtsman and our production team enabled a total of 335 bespoke precast panels and stairs to be delivered as per programme with no cost over runs.
Precast finishes were discussed and manufactured to suit clients requests as the project progressed. Architectural finishes included timber board finish, weatherboard panels, oxide colouring to concrete, acid wash finish and formliner panels.
McKendry Construction supplied 25 precast panels and 4 stairs to the Riccarton Community Centre for Watts and Hughes in 2019, Including Reid Graphic Paper and Timber Board finishes.
